Browse Items (33 total)
Sort by:
-
Michoud Assembly Facility Historical Report, January 1, 1967-December 31, 1967.
Pages 1 and 2 appear to have been cut out of the document. Page 14 is only half a page. Page 40 is repeated but each page has different information. -
"Cleaning and Contamination Control."
The document is a paper describing contamination cleaning methods and advocating for further developments in the field. Tables and figures are included at the end of the paper. The figures include a comparison of Saturn V with Saturn I and Saturn IB and cross-sections of the Saturn C-5, S-IC stage fuel tank assembly and oxidizer tank assembly. -
"Film script for Saturn I/IB quarterly film report no. 15."
Unclassified film script of the Saturn I/IB Quarterly Film Report covering January, February, March, 1963. There are handwritten notes and edits throughout the document. -
"Film script for Saturn I/IB quarterly film report no. 16."
Unclassified film script of the Saturn I/IB Quarterly Film Report covering April, May, June, 1963. There are handwritten notes and edits throughout the document. -
"A 'Zero Stage' for the Saturn IB Launch Vehicle."
To meet the demands of increasing payload size and weight, and to fill the large payload gap between the Saturn IB and Saturn V, a number of methods of uprating the Saturn IB have been studied by NASA and Chrysler Corp. of providing increased payload capability is discussed in this paper. Four 120 in. United Technology Center UA-1205 solid propellant motors, originally developed for the Air Force Titan III program, are clustered around the S-IB first stage of the Saturn IB launch vehicle. These four solid propellant motors provide the total thrust for liftoff of the vehicle, with S-IB stage ignition occurring just prior to burn-out and separation of the solid propellant motors. The term "Zero Stage" is applied to this added stage. -
"Test Laboratory progress report" March and April.
Monthly rogress report for the test laboratory regarding the Saturn 1B program between March and April. -
"Test Laboratory progress report" Febuary and March.
Monthly rogress report for the test laboratory regarding the Saturn 1B program between Feburary and March -

"Test Laboratory progress report" May and June.
Monthly rogress report for the test laboratory regarding the Saturn 1B program between Feburary and March -

"Techniques of implementing launch automation programs" (Saturn IB space vehicle system).
This paper identifies the methods and equipment through which automation is becoming a major factor in testing and launching Saturn IB space vehicles. The merits of a digital guidance computer and its impact in extending automated checkout are stressed; also a logical basis is established for computer and manual test control. Hardware and software elements of the automated system are described, and details pertaining to reliability are emphasized. A concluding appraisal suggests that automation will play an expanding role in future test and launch operations. -
"Saturn vehicles for Apollo photograph."
8 x 10 inch black and white photograph. Contains images of the Saturn V, Saturn IB and Saturn I in reference to one another -

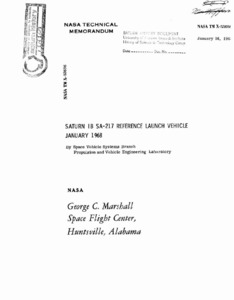

"Saturn IB SA-217 reference launch vehicle."
This document contains a definition of a reference Saturn IB launch vehicle designated SA-217. The Saturn IB SA-217 is a projected reference vehicle, based on Saturn IB SA-212, incorporating the latest proposed product improvements. The two-stage payload capability of this vehicle to a 100-nautical-mile circular orbit is 44,965 pounds. The Saturn IB SA-217 launch vehicle is to be used as the baseline vehicle for advanced studies requiring the use of the standard or modified Saturn IB launch vehicle. This vehicle definition does not necessarily represent approved changes to any specific vehicle. This document supersedes the Saturn IB SA-213 reference Launch Vehicle, described in memorandum R-P&VE-DIR-65-92. -
"Saturn IB ESE interlock system."
The results of an OMSF AS-201 Interlock and RCA 110A Computer Review were published. Recognizing that this was a "quick look", it was determined that a more detailed approach should be taken with respect to interlocks for the duration of the Saturn IB-V program. -
Saturn IB launch project development plan.
This document is an official release of Manned Space Flight and its requirements shall be implemented by all cognizant elements of Manned Space Flight Program. William Teir, Manager, Saturn IB Program; E. F. O'Connor, Director, Industrial Operations; Wernher Von Braun, Director, Marshall Space Flight Center; Samuel C. Phillips, Director, Apollo Program. -
"Saturn IB news reference."
Images, decriptions, graphics and explanations of the various Saturn rockets. -
"Saturn IB - Saturn V instrument unit technical facts."
Press release detailing the technical aspects of the Saturn IB. -
"Saturn I/IB quarterly film report no. 24, April, May and June, 1965."
A list of film reports covering the months of April, May and June of the year 1965. -
"Draft script Saturn I/IB quarterly film report no. 25."
MSFC routing slip to Mr. Lee Cropp concerning the draft copy. Contains hand-written editing suggestions, as well as a note that even if these suggestions are applied, that does not imply approval of the script for use. Covers July, August and September, 1965. -

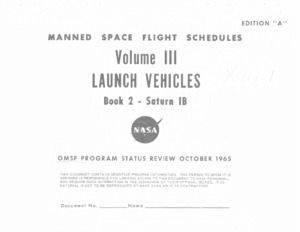

"Manned space flight schedules. Vol. III, launch vehicles : book 2, Saturn IB."
OMSF Program Status Review August 1965.; Edition "A" -

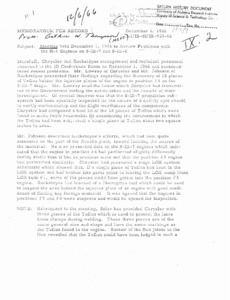

"Memorandum for record : meeting to review problems with H-1 engines on S-IB-7 and S-IB-8."
Memorandum to go over problems with the H-1 engine.
